The concrete king — introduction and timeline

person Av Ole Jone Eide
Britain has Charles,
Stockholm has Carl Gustaf,
Stavanger has Gullfaks C.
— The Royal Palace and City Hall in Oslo are small compared to Gullfaks C. Illustration: Equinor
© Norsk Oljemuseum

These three kings all have predecessors on pedestals, and from the very first
they were destined for important public tasks. But only one of them has left a
record-breaking mark on the continental shelf thanks to its unique combination
of mobility and mass.

In that sense, Gullfaks C is king of kings.

At production start in 1989, Gullfaks C was first, heaviest and tallest in
key areas within the Condeep universe. And as for the rest of the universe, the
platform was by far the heaviest object ever moved by humans.

But setting a record is one thing. Setting a record that endures is another.
Gullfaks C weighed 1.5 million tonnes when it was towed out to the field in
1989. That record has stood ever since—and no one is likely to move anything
heavier anytime soon.

Gullfaks C in 2006. Photo: Øyvind Hagen/Equinor

Here follows the story of this unique structure:

Building the base section
The tow from Gandsfjorden to Vats
Slipforming and mechanical outfitting
The tow from Vats to Stord                                                                                                                      The Gullfaks C mating                                                                                                                 Constructing the topside
The tow from Stord to the field
Offshore commissioning                                                                                                                            Production start

Timeline — Gullfaks C

A) Concrete substructure[REMOVE]Fotnote: The numerical data is partly sourced from Hansen, Thorvald Buch et al. (1990). Gullfaks – Glimpses from the History of a Fully Norwegian Oil Field. Stavanger: Statoil, pp. 55, 86 and 110.

1986 (winter): Start of construction, base section,
Hinna/Jåttåvågen
1986 (late February): Contract signed between Statoil [now Equinor] and
NC (Norwegian Contractors)[REMOVE]Fotnote: Construction began before the formal contract was signed.
1987 (25–26 May): Tow from Gandsfjorden to Vats
1987 (July–August): Main slipforming (24 cells — height 56 meters)
1987 (September–January 1988): Casting of the cell roofs
1988 (17 February–approximately 20 April): Shaft slipforming (four shafts —
height 165 meters)
1988 (30 December–3 January 1989): Tow Vats–Digernessundet, Stord
1989 (27 February): Mated to the steel topside in Digernessundet

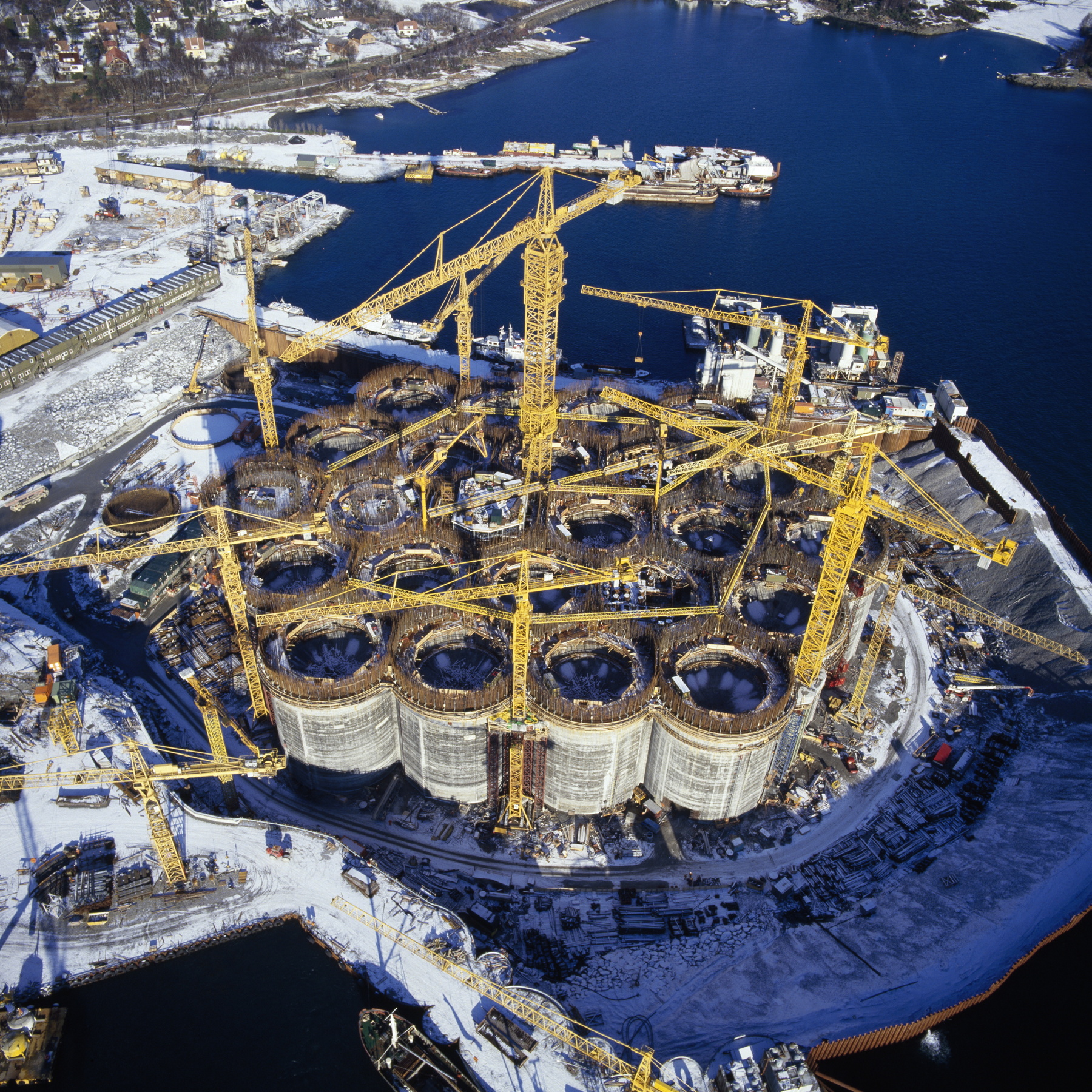

The bottom section of Gullfaks C under construction in the dry dock at Hinnavågen. Photo: Leif Berge/Equinor

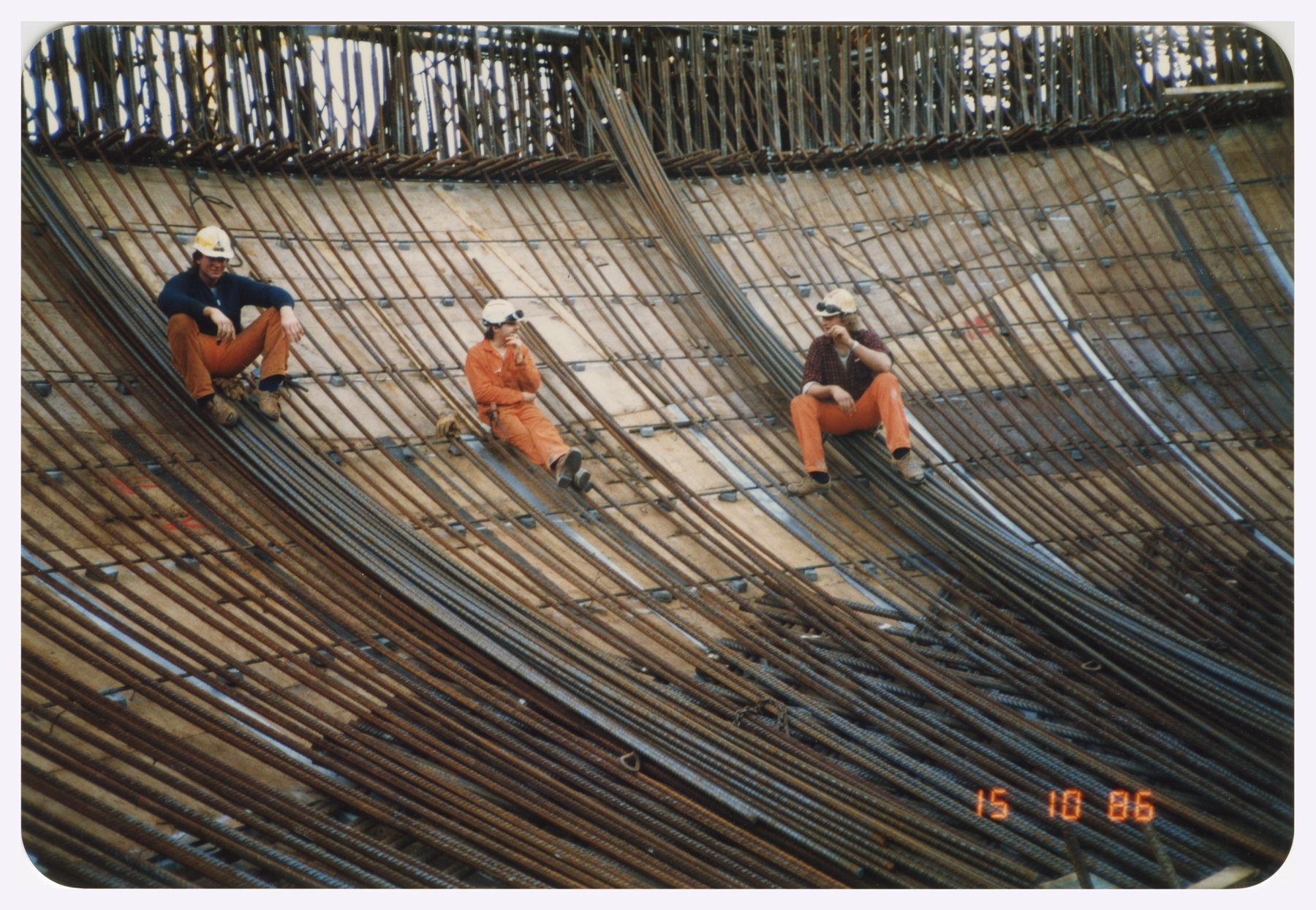

A short break from work on one of the cells in the bottom section. Photo: Unknown/Norwegian Petroleum Museum

B) Steel topside[REMOVE]Fotnote: Much of the information is sourced from Resser, Tor (26 April 1989). “Offshore Work Strategically Important.” In: Sunnhordland, 26 April 1989, p. 5.

1986 (11 September): Statoil awards the contract to Aker Stord
1986 (5 October): Production starts in the plate shop
1987 (13 February): Work in the dock begins
1987 (26 June): Half of the topside’s Module Support Frame (MSF) arrives at Aker Stord from Aker Verdal
1988 (17–22 March): 21 modules are installed on the topside’s MSF
1989 (27 February): Mated to the concrete substructure in Digernessundet

The deck of Gullfaks C en route to Digernessundet, where it will be connected to the substructure. Photo: Rolf C T Nielsen/Norwegian Petroleum Museum

C) The platform

1989 (12 April): Naming ceremony
1989 (2 May): Tow-out to the field begins
1989 (8 May): Set-down on the field begins
1989 (6 July): Conductor driving
1989 (1 October): Start of drilling
1989 (4 November): Start of production (oil from GFB)
1989 (18 December): Formal marking of production start
1990 (8 January): First well tied into the processing system on Gullfaks C

Gullfaks C. Illustration: Patrick Mathews/Equinor

Facts

Substructure weight: approximately 1,500,000 tonnes (of this around 70,000
tonnes of reinforcing steel)
Topside weight: approximately 50,000 tonnes
Footprint: approximately 16,000 m² (≈ 1.6 hectares)
Total height: 380 meters (substructure 262 meters + topside) (GFA/GFB: 270/220
meters total height)
Water depth: 216 meters
Beds: 330 (220 single cabins, 55 double cabins)[REMOVE]Fotnote: Resser, Tor (25 April 1989). “The Giant at 34/10.” In: Sunnhordland,
25 April 1989, p. 7.

Production capacity: 245,000 barrels per day
Storage capacity: 275,000 m³ (2 million barrels)
